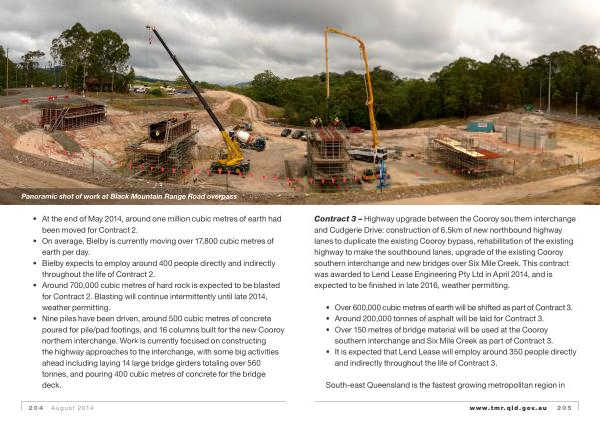

Panoramic shot of work at Black Mountain Range Road overpass
• At the end of May 2014 , around one million cubic metres of earth had been moved for Contract 2 .
• On average , Bielby is currently moving over 17,800 cubic metres of earth per day .
• Bielby expects to employ around 400 people directly and indirectly throughout the life of Contract 2 .
• Around 700,000 cubic metres of hard rock is expected to be blasted for Contract 2 . Blasting will continue intermittently until late 2014 , weather permitting .
• Nine piles have been driven , around 500 cubic metres of concrete poured for pile / pad footings , and 16 columns built for the new Cooroy northern interchange . Work is currently focused on constructing the highway approaches to the interchange , with some big activities ahead including laying 14 large bridge girders totaling over 560 tonnes , and pouring 400 cubic metres of concrete for the bridge deck .
