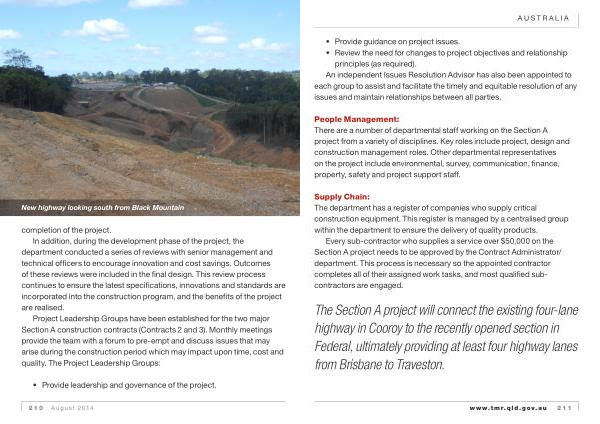

Construction Magazine August 2014 | Page 211

australia
• Provide guidance on project issues .
• Review the need for changes to project objectives and relationship principles ( as required ).
An independent Issues Resolution Advisor has also been appointed to each group to assist and facilitate the timely and equitable resolution of any issues and maintain relationships between all parties .
People Management : There are a number of departmental staff working on the Section A project from a variety of disciplines . Key roles include project , design and construction management roles . Other departmental representatives on the project include environmental , survey , communication , finance , property , safety and project support staff .
Supply Chain : The department has a register of companies who supply critical construction equipment . This register is managed by a centralised group within the department to ensure the delivery of quality products .
Every sub-contractor who supplies a service over $ 50,000 on the Section A project needs to be approved by the Contract Administrator / department . This process is necessary so the appointed contractor completes all of their assigned work tasks , and most qualified subcontractors are engaged .

The Section A project will connect the existing four-lane highway in Cooroy to the recently opened section in Federal , ultimately providing at least four highway lanes from Brisbane to Traveston . www . tmr . qld . gov . au 211
